Fort Lauderdale Permeation Grouting
The Job

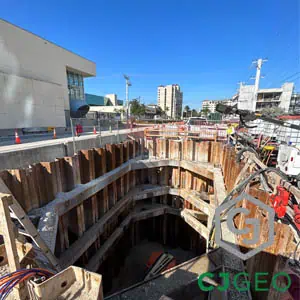

This Fort Lauderdale permeation grouting project is located next to Port Everglades. Port Everglades is a crucial piece of Florida’s infrastructure, with annual economic impact exceeding $30 billion dollars per year. The tunnel, which is being mined with a 72″ MTBM, crosses under Eisenhower Boulevard from the George T Lohmeyer Wastewater Treatment Plant towards the Broward County Convention Center.
The tunnel is more than 20′ below grade, below the water table, in limestone with pockets of silty sand.
The Challenge
On this project, the microtunneling contractor had two tunnel crossings. On the first, they elected to not pre-grout their break in & break outs through the SOE. This resulted in a significant water and soil inflow event during the first break in. This crossing, under the entrance to the cruise port and between two other pieces of critical infrastructure, would not tolerate any surface disturbances associated with a flooding event.
The contractor reached out to CJGeo about stabilizing the launch & retrieval shafts to ensure stability during the launch & retrieval processes, by performing permeation grouting.
The Solution
CJGeo proposed permeation grouting of the limestone with an acrylic grout to ensure stability of the launch & retrieval shafts. Permeation grouting with acrylic grout ensures uniform permeation, and displacement of groundwater. It also ensures that the soils are sufficiently bound together to not fail while cutting the launch & retrieval holes in the sheet pile.
CJGeo installed the sacrificial tubing for this installation from the shaft. Occasionally, sonic drilling is useful for pre-grouting, but in this case, it was more economical and less disruptive to go through the shaft walls.
CJGeo performed the permeation grouting work in a single shift at each shaft.
Speak With An Expert
Facing a similar challenge to this Fort Lauderdale permeation grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
TBM Intervention Permeation Grouting
The Job
This TBM intervention permeation grouting project is located in Virginia. It is part of a highway tunnel installation project to increase capacity on a bridge tunnel.
The Challenge
During mining, the TBM, which is more than 40′ in diameter, began to pull pieces of sheet pile & wire rope through the face. To prevent further damage to the machine, tunneling was stopped. The machine encountered the debris approximately 250 feet short of the exit structure, underneath a constructed island.
The island is built out of relatively loose beach sand that’s commonly available in the area. The crown of the machine is approximately 25′ below grade, with the invert of the machine being about 70 feet below grade. Mean high tide is also about 25′ below grade.
In order to facilitate a hyperbaric intervention, the contractor needed a solid plug in front of and around the machine face. The criteria for the plug included:
- easily excavatable, to prevent issues for the TBM upon resumption of mining, and also to ensure that divers doing the hyperbaric intervention wouldn’t have issues removing grouted material in the case of grout entry into the machine face.
- low viscosity, to ensure uniform permeation into the soils in front of the machine, though they were relatively course (only 1% fines)
- readily available, in order to meet the incredibly short schedule requirement
The Solution
CJGeo proposed permeation grouting to create the plug using acrylic grout. Acrylic grout is:
- readily available through the mining supply chain
- very low viscosity, so well suited for permeating sands
- forms a stiff gel that’s stable, but still easily hand-excavatable
To perform permeation grouting up to 75 feet below grade, CJGeo proposed sonic drilling to install Tube-a-Manchette (TAM) pipes.
Due to the compressed timeframe, CJGeo subcontracted a sonic driller to install 86 different TAM wells, ranging from 25 to 75 feet deep. Once the first 10 TAM tubes were in place, CJGeo started placing acrylic grout through up to 10 simultaneous TAM pipes, using straddle packers and a PLC-controlled grouting system.
CJGeo was onsite within 10 days of the first call. Then, over 23 calendar days, CJGeo successfully installed more than 85,000 gallons of acrylic grout, at rates of nearly 15 gallons per minute.
Speak With An Expert
Facing a similar challenge to this TBM intervention permeation grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
Indoor Pool Abandonment
The Job

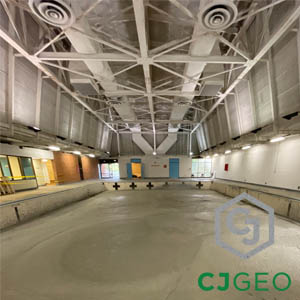

This indoor pool abandonment project is located in West Virginia, at Concord University. A swimming pool built in the 1970’s was no longer in use, and had sat empty for years. As part of a renovation, the pool had to be filled in order to pour a slab and prepare the room for other uses.
The Challenge
Like many buildings in the mountains, the original site sloped. A retaining/basement wall passes through the building close to the deep end of the pool, whose sloped floor roughly follows the original grade of the site. The structural engineer had to concerns about backfilling the pool:
- increasing lateral loads on the adjacent basement wall if a heavy, granular material was used for the fill material
- causing settlement by filling the pool with material heavier than the water it was designed to hold, and which the underlying soils had seen for years
The original bid had two options: filling the pool entirely with 57 stone, or filling it entirely with 2lb/cuft EPS blocks.
The Solution
Geofoam blocks would have addressed both the axial and lateral load challenges. However, EPS would take a few weeks to import, cut, and place. 57 stone would have been least expensive, but increased lateral and axial loads beyond those of water.
CJGeo proposed a value engineered alternative to fill the bottom 70% of the pool with 25lb/cuft CJFill-Ultra Lightweight low density cellular fill (LDCF), topped with 57 stone, and then a new floor slab. The structural engineer, architect and owner all accepted the proposed change. The general contractor was excited to save weeks out of their schedule.
A single CJGeo dry batch cellular concrete crew performed the work over two days. The first lift, of 400 cubic yards took about two hours to place, and was roughly 6 feet deep. The second lift, around 350 cubic yards, also took about two hours to place. The day after CJGeo wrapped up, the general contractor was able to start placing the 57 stone on top of the CJFill-Ultra Lightweight fill.
Speak With An Expert
Facing a similar challenge to this indoor pool abandonment project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
WWTP Tunnel Curtain Grouting
The Job
This WWTP tunnel curtain grouting project is located in Syracuse, New York. It is located immediately adjacent to the southern shore of Onandaga Lake in an area that is historical infill.
The Challenge
A 700 foot long, 17 feet deep utility tunnel runs through the treatment plant site. Inside are numerous site utilities, including large diameter waste lines, along with many smaller diameter chemical and treatment lines.
Over time, the tunnel walls have developed leaks, accentuated by the highly variable fill material outside of the structure. When it rains, water enters the tunnel, which has roughly three feet of cover.
The Solution
As part of a large project at the plant, plans call for curtain grouting the length of the tunnel with polyurethane grout. Curtain grouting can be done two ways:
- through the structure walls, using holes drilled through the structure, or
- from the surface, using tubing inserted down along the exterior face of the wall
In this case, the interior walls of the tunnel were not uniformly accessible due to the number of utilities mounted on the wall. CJGeo designed a grouting program using the sacrificial tubes from the surface method. The advantage of this method in this case was that the density of utilities on the inside face of the structure didn’t affect the ability to uniformly introduce grout along the outside surface of the structure.
A CJGeo chemical grouting crew placed nearly 1300 gallons of single component polyurethane resin on this WWTP curtain grouting project. The work took about three weeks start to finish. The general contractor had removed the backfill and installed a new waterproofing membrane over the tunnel lid and extending down the walls about one foot on each side.
Speak With An Expert
Facing a similar challenge to this WWTP tunnel curtain grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
Flooded Shaft Grouting
The Job

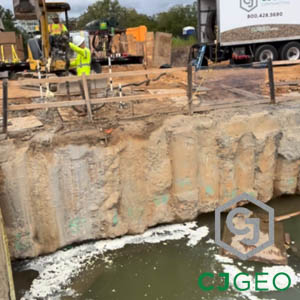

This flooded shaft grouting project by CJGeo is located outside of Washington, DC at a data center site. As the 60″ microtunneling machine was entering the retrieval shaft, a piece broke off of the secant pile wall, and tore the seal. This resulted in water infiltration of around 600 gallons per minute into the shaft. The machine was recovered, but the shaft filled with nearly 15 feet of water in a matter of hours.
The casing crown has roughly 20 feet of cover, and is about 15 feet below the ground water level. The ground in the area is a mix of clays and sands. The tunnel is primarily in the underlying fractured rock. For the last 30 feet of tunnel before the secant pile receiving shaft, the tunnel is in a mix of weathered rock and sandy clay.
The Challenge
Having used CJGeo in the past to address high volume leaks into shafts, the tunneling contractor reached out to CJGeo for this flood shaft grouting problem. The primary constraints were:
- time – the project was already behind schedule
- water management – any groundwater was considered contaminated
Typically, grouting a leak such as this would be as simple as throwing bigger pumps into the shaft, dewatering it, then grouting the leak from inside the shaft. However, because of the costs associated with treating potentially very high volumes of water at this site, this wasn’t an option.
The Solution
CJGeo proposed, and then successfully performed, a two stage grouting program. Primary grouting was done using CJGrout 35NHV61 geotechnical polyurethane on a Saturday. The CJGrout 35NHV61 was installed immediately behind the secant pile wall through three holes drilled from the surface to intercept the over cut. Grout injection through these holes resulted in grout return to the retrieval shaft. Off gassing also showed up at the launch shaft. This indicates that the rapid inflow of water during the flooding event had washed out some of the mud in the over cut.
After completion of the plural component primary seal injection, CJGeo dye tested the primary grouting program. This was done through Tube-A-Manchette grout pipes installed using sonic drilling along the tunnel alignment, further out from the shaft. No dyed water returned to either shaft.
The following day (Sunday), CJGeo performed permeation grouting using colloidal silica through the TAM grouting tubes. This secondary grouting program served two purposes:
- seal any rock fractures that weren’t penetrable by the higher viscosity plural component polyurethane grout
- replace any overcut mud washed out during the initial flooding event
Speak With An Expert
Facing a similar challenge to this flooded shaft grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
New Jersey permeation grouting
The Job
This New Jersey permeation grouting project is located in Elizabeth, New Jersey. It is at a large wastewater treatment plant owned by the JMEUC.
The Challenge
During installation of a new building on site, a large excavation was required. Primarily comprised of H piles and wood lagging, it crossed a 24 foot wide influent conduit. The influent conduit is a double barrel box structure, cast in place on 12 inch thick bed of open graded stone.
During test pitting to the bottom of footing elevation, the test pit appeared to be tidally influenced. The site is immediately adjacent to a creek that feeds into the Elizabeth River. At high tide, and due to the permeability of the stone layer, inflow into the test pit was not controllable, and was higher than the footing elevation.
Specific challenges here included:
- potentially high velocity water flows due to tidal influence
- 12 foot minimum spacing of grout holes due to structure wall locations
- potential fouling of bedding stone with fines
The Solution

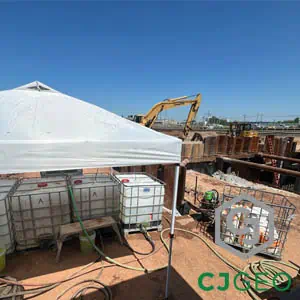

The general contractor reached out to CJGeo about grouting the stone bed. The structure is 24 feet wide, but only has a single, eight inch wall down the middle.
CJGeo proposed that a coring contractor drill a two inch core down through the center and side walls from the surface. This gave us three access points to place grout from at each location.
Due to the large grout hole spacing, CJGeo selected acrylic grout. Acrylics are excellent for this type of application because they are exceptionally low viscosity (pump & flow pretty much like water).
A single CJGeo chemical grouting crew performed the acrylic grouting over two days onsite. Afterwards, infiltration into the excavation was down to a submersible garden hose pump. The use of acrylic grout ensured that:
- coverage was uniform despite the large distance between placement points
- any fines fouling the bedding stone were uniformly bound together, immobilized & made impermeable
Speak With An Expert
Facing a similar challenge to this New Jersey permeation grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
Outfall Leak Grouting
The Job
This outfall leak grouting project is located near Emporia, Virginia. The work is located at two different stormwater ponds at an industrial scale solar facility. The facility is owned by Dominion Energy.
The Challenge
This facility has a mix of both dry and wet ponds. At two wet ponds, leaks developed along the outfall pipes, which prevented them from holding water long term. During a precipitation event, water would build up, but then afterwards, slowly drain out by piping alongside the outfall pipes. In order to turn over the facility to the owner, the contractor needed to address the leaks to ensure the ponds functioned as designed.
The Solution
Due to the small diameter of the pipes, they weren’t accessible from the inside. CJGeo proposed grouting along the pipe alignments using single component expanding chemical grout. The pipes are reinforced concrete.
To facilitate this, CJGeo drove sacrificial injection tubes along both sides of each of the two pipes. No grout returned to the inside of the pipes, which confirms that the root cause of the problem was poor control of the backfill, as opposed to problems with the pipe joints. When bedding isn’t properly installed, and backfill properly compacted, water can flow outside of stormwater pipes, which is what was happening here.
Speak With An Expert
Facing a similar challenge to this outfall leak grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.

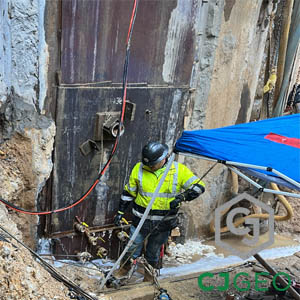

SOE Leak Grouting
The Job
This SOE leak grouting project is located in Alexandria, Virginia. It is part of the RiverRenew project, which is a large CSO tunnel and drop shaft project. This location is immediately adjacent to the Woodrow Wilson Bridge, and the Potomac River.
The Challenge
At a drop shaft location, the contract installed two parallel slurry walls between an existing combined sewer box culvert and a drop shaft to the new tunnel. During excavation of the pit, two high volume leaks, each around 125GPM opened up below the existing conduit.
The customer installed road plates to stabilize the area, and pumped flowable fill behind the road plates. This provided short term stability to the area, but did not address the high velocity flow of water through an unanticipated open graded sand seam that was causing the leaks.
The Solution
CJGeo mobilized a grouting crew capable of performing both high volume geotechnical polyurethane grouting and acrylic permeation grouting at the same time for this SOE leak grouting work. The first step was to install CJGrout 35NHV61 to fill voids which had washed out immediately behind the road plates.
After grouting the bulk voids and slowing the velocity of the leaks, CJGeo installed acrylic grout up to 20 feet behind the slurry wall face. The only way to reliably stop water flow through sands is to bind them together with a very low viscosity grout. The acrylic grout installed on this project has a viscosity less than 10 centipoise. This allows it to uniformly permeate the sands, react into a cooked egg white consistency, and make the treated sands impermeable.
Speak With An Expert
Facing a similar challenge to this SOE leak grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
SOE Closure Manchette Grouting
The Job
This SOE closure Manchette grouting project is located in Alexandria, Virginia. It is part of the RiverRenew project, a large CSO project.
The Challenge
As part of this project, a diversion structure and drop shaft were being installed to pull flow off of an existing sewer tunnel. The box tunnel is around 8′ wide. The SOE will facilitate installation of the diversion chamber. Excavation within the SOE called for closing the gap between slurry wall panels. This is to be done under the existing structure with steel lagging.
However, the closure is below ground water table. The “marsh” deposits soils require stabilization prior to excavation. The conceptual design from the owner called for permeation grouting tied into an underlying clay layer. The clay layer is approximately 50′ below existing grade.
The Solution
CJGeo proposed performing the permeation grouting to cut off ground water flow and stabilize the soils for excavation using an acrylic grout. Due to the relatively deep required depth, traditional percussion driven installation tubing wasn’t possible. CJGeo used sonic drilling to install the TAM tubing.
To ensure accurate placement at depth, CJGeo used the TAM grouting method. TAM grouting, or Tube-a-Manchette, uses special grout casing installed by drilling to grout through.
CJGeo performed this SOE closure Manchette grouting work over a period of two weeks.
Speak With An Expert
Facing a similar challenge to this SOE closure Manchette grouting project? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
Sheet Pile Joint Sealing
The Job

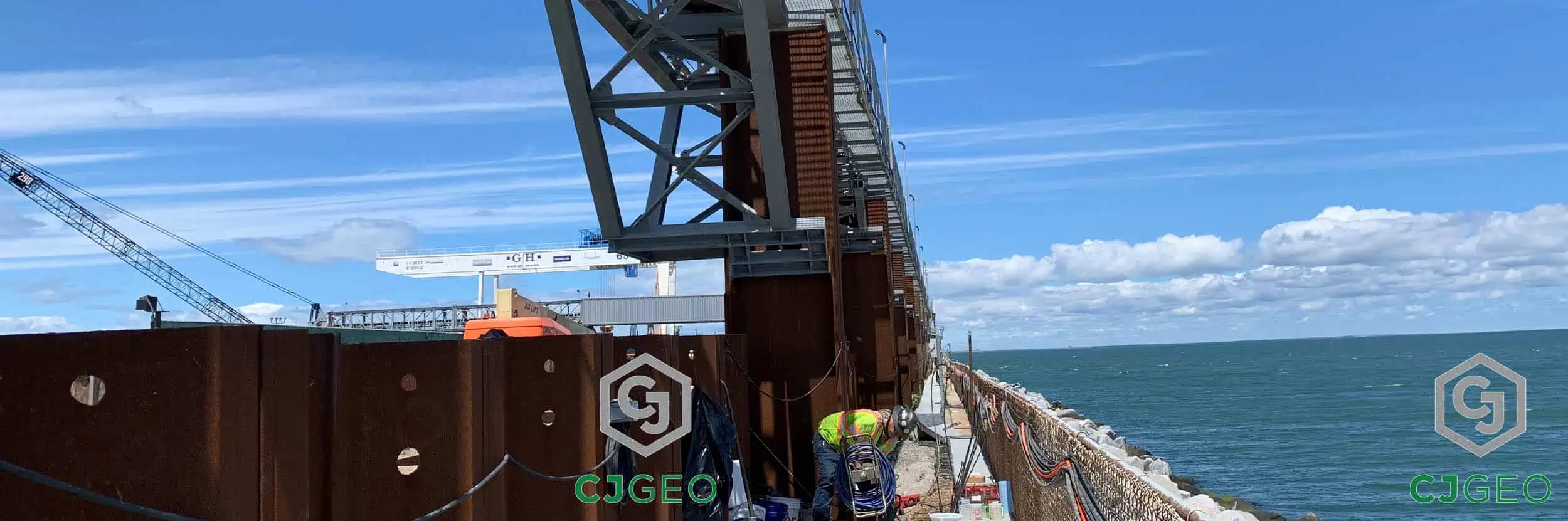

This sheet pile joint sealing work is part of the Thimble Shoals parallel tunnel project. The project is located between Islands 1 and 2 of the Chesapeake Bay Bridge Tunnel. The Chesapeake Bay Bridge Tunnel crosses the opening of the Chesapeake Bay, connecting Norfolk/Virginia Beach and the Eastern Shore.
The Challenge
Water was leaking out of a joint in the precast splash wall adjacent to the TBM slurry separation pit. Any time it rained, precipitation landing in the slurry pit would flow out of gaps in the sheet pile wall. It then passed through the roughly 3′ of soil between the sheet pile wall and splash wall, and then out through joints in the splash wall.
The Solution
CJGeo proposed using a single component, hydrophilic chemical grout to seal the joints. Hydrophilic grout is best for this particularly repair because:
- the area is rather dynamic, so hydrophilic’s ability to flex and stretch without tearing helped to ensure longevity
- the area is constantly exposed to moisture, so dimensional stability is not a concern.
A CJGeo chemical grouting crew of three people completed the sheet pile joint sealing repairs in less than a day. Some chemical grout extruded out through the joint in the splash wall. It was broken off flush with the surface and disposed of offsite.
Speak With An Expert
Facing a similar challenge? Give us a shout or shoot us a text. Click the state marker for the location of your project for contact info for the appropriate rep.
